Chapters

7 Network Design Readiness

network-topologies
impl
five
considerations

A network design becomes real when cables, radios, power supplies, addresses, and maintenance access meet the site. Five readiness considerations keep a tidy diagram from skipping physical constraints. The release question is whether the built path supports the required devices and failures with traceable evidence.

A payload is the application data travelling on a link, and a protocol is the rule used to exchange it.

7.1 Turn the Design Map Into a Readiness Decision

Read Figure 7.1 across its five labelled concerns. Connect each one to the same deployment rather than treating them as independent checklist boxes. Coverage affects placement; capacity affects shared links; reliability exposes failure domains; security limits reachable paths; operations determine how faults and changes are handled.

Figure 7.3 captures the proposed nodes, links, roles, assumptions, and version. Follow that record into Figure 7.2, where measurements and tests support or challenge the proposal. Figure 7.4 ends the sequence with accept, correct, pilot again, or stop. The gate should cite evidence, not confidence in the drawing.

Consider 30 warehouse sensors sending one 120-byte payload every minute. Application data entering the gateway is (30\times120=3{,}600) bytes per minute before protocol overhead and retries. Capacity testing should include synchronized reporting, because thirty devices transmitting at the minute boundary can create a short burst even when the average rate is small.

Coverage evidence names the farthest and most obstructed sensors. Reliability testing removes the gateway, a shared switch or relay, and power to one zone. Security testing attempts a route that policy should deny. Operations testing asks whether staff can identify a missing sensor, replace it, and confirm its identity without weakening credentials.

Traceability connects every hard need to a result. “All 30 sensors report within two minutes” maps to an observed burst test. “One sensor must not reach the office network” maps to an allowed-and-denied path test. “A relay loss may affect at most five sensors” maps to the topology record and a physical fault drill.

Predict the readiness review. Expect 30 unique identifiers after the synchronized burst, not merely 30 messages. Remove each shared component and list the exact expected losses before observing them. Attempt the forbidden office route and expect a logged denial. If a requirement has no test or a test has no limit, the design is not ready for release even when basic connectivity works.

7.2 Start With the Story

Imagine planning sensors for a school building. A line on a drawing does not show whether a battery can last, a message can arrive, or a broken device can be replaced. A protocol is a set of rules for exchanging messages. A gateway is a bridge between a local device network and a wider system.

Begin with five facts: device limits, message needs, site boundaries, device addresses, and the planned network shape. Use those facts to reject choices that cannot work. Then test a sleeping device, a burst of messages, a blocked path, and a failed gateway. Keep the result beside the drawing so a later change reopens the right decision.

Use one sheet for the five facts. For each device, write power, sleep, place, and owner. For each message, write size, direction, rate, and deadline. Draw where local systems meet outside systems. Give each device a stable address plan. Draw normal and backup paths. Mark every point whose loss stops the service. Add the test that supports each arrow. Add the person who keeps that test current.

Now change one fact. Add devices, remove a path, or shorten a deadline. If the design record cannot show what must be checked again, it is not ready for release.

This first review cannot predict every wall, radio, or maintenance event. The Practitioner section turns the five facts into a release record. Under the Hood follows scale, routing, and failure trade-offs.

Before a network design is ready, someone has to connect the drawing to the release evidence. The five considerations in this chapter keep that story together: device constraints, data behavior, infrastructure boundaries, addressing, and topology records. Each one answers a practical review question before the network is trusted in the field.

7.3 Overview: Design Starts With Traceability

A good IoT network design is not a protocol shopping list. It is a traceable design record that links device constraints, data behaviour, infrastructure boundaries, addressing, topology views, security zones, operations, and release checks. A choice is ready only when the team can trace it to a requirement and recheck it when the deployment changes.

The five considerations stay connected. Device limits shape data behaviour. Data behaviour shapes gateway and backhaul choices. Infrastructure boundaries shape addressing and naming. Topology records show how those choices appear in logical, physical, and operational views.

For example, a sleeping battery sensor, a line-powered gateway, and a cloud dashboard may all appear in one network diagram, but they need different evidence. The sensor record should explain power budget, reporting cadence, retry tolerance, and service access. The gateway record should explain buffering, translation, backhaul, update ownership, and local diagnostics. The dashboard path should explain freshness, access boundary, retained state, and alert handling. Once those records exist, a topology choice becomes reviewable: the team can say why a star, mesh, tree, or hybrid pattern fits this deployment instead of relying on the default pattern from a previous project. If any record is missing, the design response is not to guess a better protocol; it is to mark the missing evidence and delay the release decision that depends on it.

Start with requirements when designing a new network. Start with missing records when assessing an existing design.

Protocol choice is premature until the design inputs can be traced to a release claim. Figure 7.1 gathers those inputs so the rest of the chapter can treat them as one maintained record rather than five independent checklists.

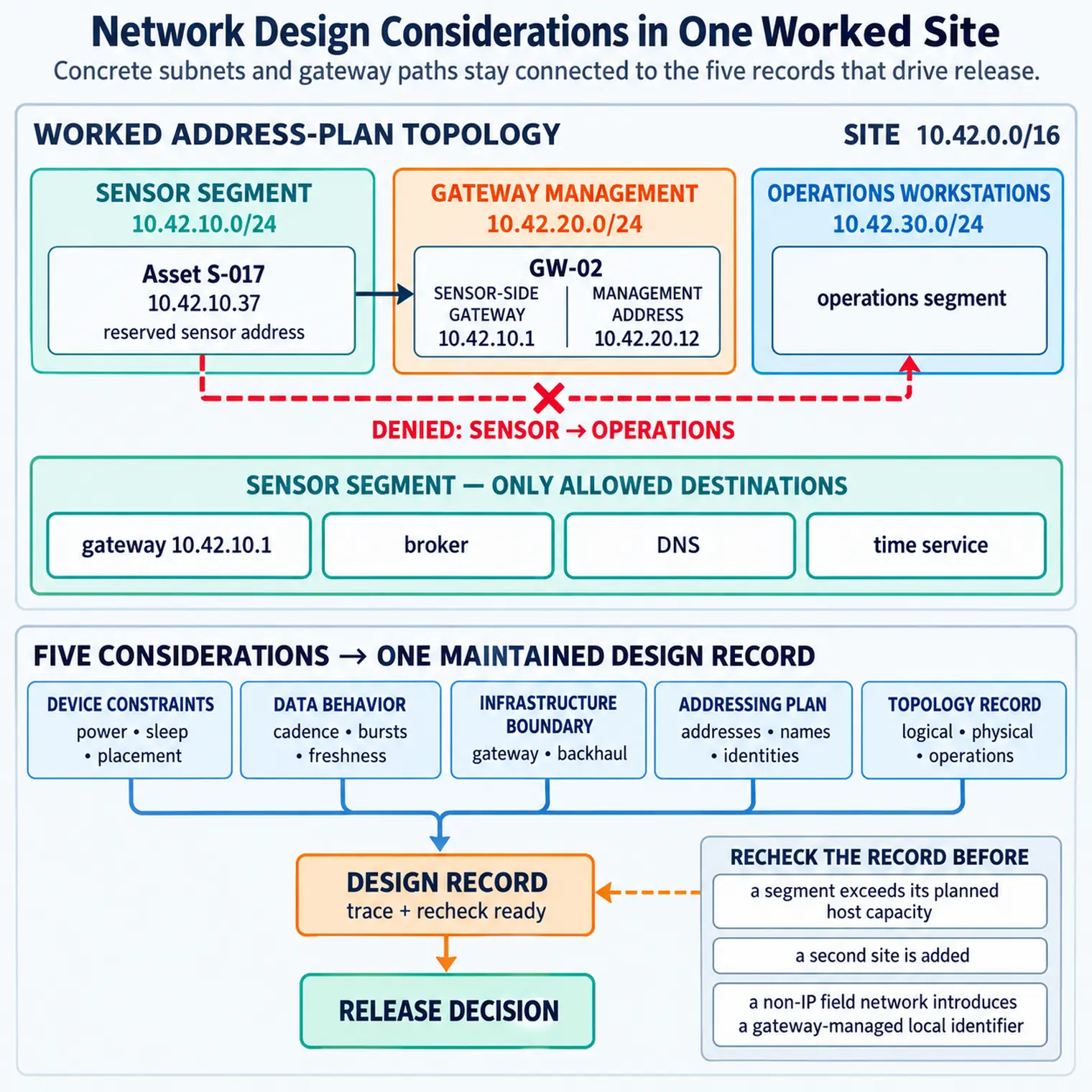

Network design consideration map: device constraints, data behaviour, infrastructure boundary, addressing plan, and topology record feed a central design record that drives the release decision.
Figure 7.1: The design record connects device, data, infrastructure, addressing, topology, and release readiness

Around Figure 7.1, Device Constraints contributes power, sleep, and placement while Data Behavior contributes cadence, bursts, and freshness. Infrastructure Boundary, Addressing Plan, and Topology Record then converge on the central Design Record, which must be trace and recheck ready before it yields a Release Decision. That convergence is the chapter’s running narrative: every protocol, gateway, and address choice needs a visible requirement behind it and a trigger that says when its evidence has gone stale.

Device constraints

Power source, sleep behaviour, protocol capacity, placement limits, mobility, maintenance access, and ownership.

Data behaviour

Cadence, bursts, freshness, direction, reliability tolerance, duplicate handling, and sensitivity.

Infrastructure

Gateway, backhaul, segmentation, platform boundary, buffering, monitoring, and incident response ownership.

Addressing and topology

Address plans, names, identities, logical flows, physical placement, operations views, and recheck triggers.

Overview Check

7.4 Practitioner: Build the Record Before the Diagram

The design record should produce consequences, not just inventory facts. A battery sensor may need restrained reporting, local filtering, a sleepy receive policy, and gateway-assisted translation. A mains-powered gateway can support richer conversion and health reporting, but still needs placement, backhaul, recovery, and ownership evidence.

Data behaviour is the second pressure point. Average bandwidth is rarely enough. A network can look small on average and still fail during alarms, startup storms, gateway recovery, maintenance windows, retry loops, or synchronized reporting. Record representative bursts and recovery behaviour before accepting a topology or protocol.

Make the burst record concrete enough to test. A useful entry separates routine heartbeats, event messages, commands, diagnostics, and firmware or configuration traffic. It names which flows can be delayed, which must stay fresh, which may duplicate safely, and which require acknowledgement before the device sleeps again. It also states the retry limit and the recovery path after a gateway outage. Those details drive design choices: local buffering may matter more than peak radio speed, gateway placement may matter more than cloud features, and a simple addressing plan may reduce support risk more than a clever topology.

Protocol choice should also name the first physical and traffic questions explicitly: required distance, deployment area, payload volume, speed, message frequency, freshness need, power source, and whether the device can remain on continuously. A short-range deliberate tap may point toward NFC, a wide-area small-payload sensor may point toward LoRaWAN or cellular IoT, and a powered high-volume device near managed infrastructure may point toward Wi-Fi or 4G. Those names are only candidates until the record proves the device, link, service, and operations boundaries.

Small case studies make the record concrete. A dairy-farm entry tag read at a controlled gate within a few metres may justify passive UHF RFID evidence; kilometre-scale coverage requires a different active or wide-area radio system. A foot-drop wearable may be closer to PAN or Bluetooth evidence. A mobile bus path may combine wired links, LTE or 4G, GPS, RF, and Wi-Fi. A bridge monitoring site may justify fibre or Ethernet. A campus project with limited data and range may fit LoRaWAN, while rotating-machine monitoring may compare Bluetooth LE, Wi-Fi, LoRa, or Zigbee depending on access and range. The point is not the label; the row records device class, range, power, payload, environment, and owner before accepting the media choice.

Worked address-plan example

A small IP-capable sensor site receives 10.42.0.0/16. The designer assigns 10.42.10.0/24 to the sensor segment (gateway 10.42.10.1), 10.42.20.0/24 to gateway management, and 10.42.30.0/24 to operations workstations. Asset S-017 maps in inventory to its radio or MAC identity, its reserved sensor address 10.42.10.37, and gateway GW-02 at 10.42.20.12. The access rule allows the sensor segment to reach only its gateway, broker, DNS, and time service; it cannot initiate sessions to the operations segment. The record must be revised before a segment exceeds its planned host capacity, a second site is added, or a non-IP field network introduces a gateway-managed local identifier.

In an internet-connected tilt-maze style prototype, the tablet command path, cellular or Wi-Fi access, cloud hop, Ethernet link to the controller, microcontroller-to-actuator interface, and camera return path exercise different layers. The review should name which layer owns each question: application message, transport reliability, IP route, network-access link, and local hardware interface. Non-IP or constrained links should terminate at a gateway that translates, buffers, and exposes diagnostics instead of pretending every endpoint speaks the same TCP/IP stack.

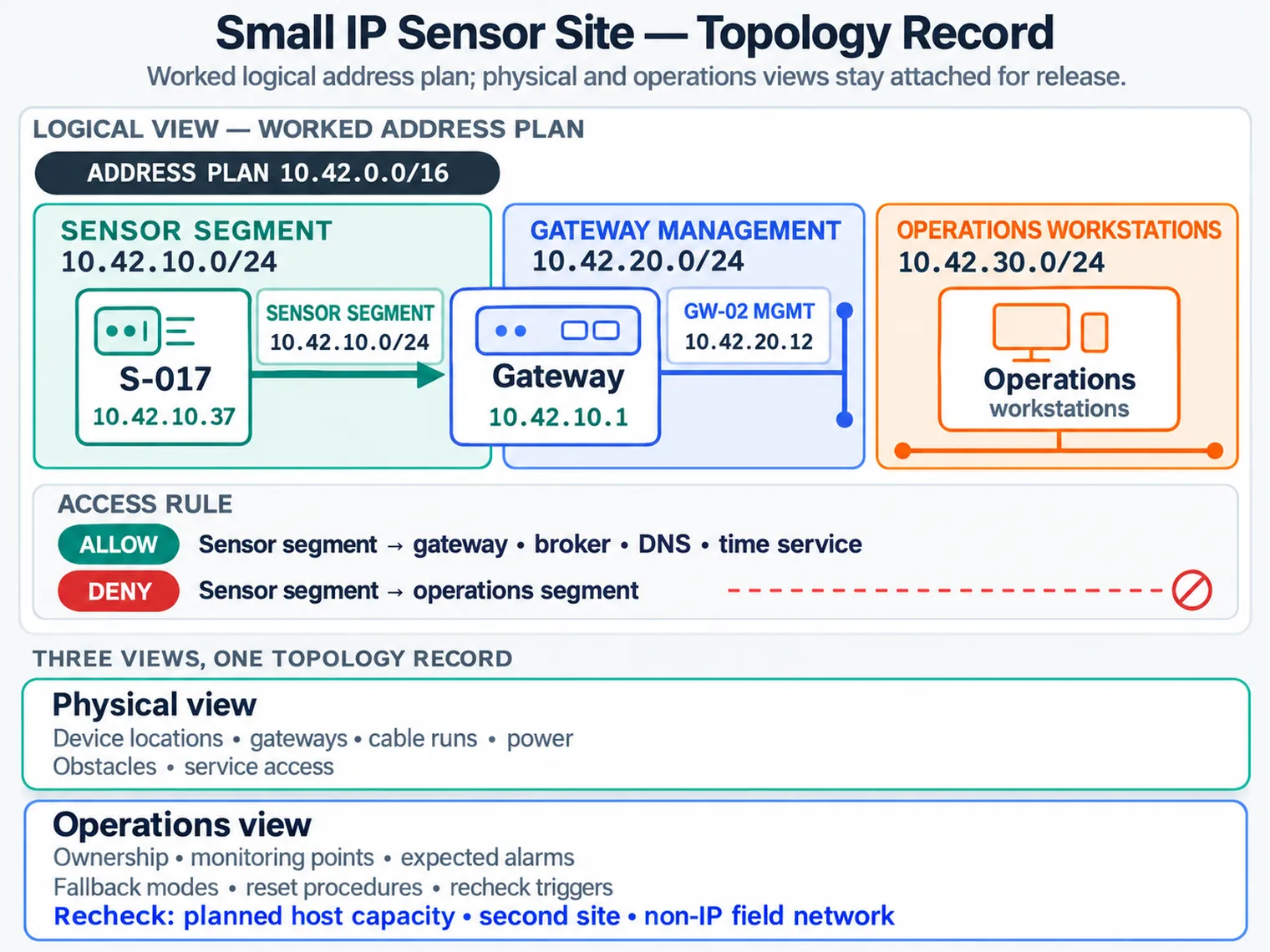

The worked address plan is credible only if its subnet and access choices remain connected to device and traffic evidence. Figure 7.2 shows where those choices enter the design chain and which supporting records keep them reviewable.

Network design evidence chain: device record, data profile, protocol fit, gateway boundary, and release decision, supported by measurements, exception log, and operations evidence.
Figure 7.2: Device and data records drive protocol, gateway, addressing, topology, and operations decisions

In Figure 7.2, Device Record names module, power, and I/O constraints while Data Profile contributes bursts and recovery behaviour. Those inputs narrow Protocol Fit and the Gateway Boundary, where translation and buffering occur, before the Release Decision asserts that topology and operations are ready. The dashed supports matter too: Measurements, Exception Log, and Operations Evidence supply coverage results, bounded weak spots, and named health owners. The 10.42.10.0/24 sensor segment above therefore belongs in this evidence chain, not in an isolated addressing table.

Record area
Minimum record
Design consequence
Common shortcut
Device class
Power, sleep, placement, protocol capacity, service access, and ownership.
Constrains reporting rate, gateway role, maintenance model, and remote management path.
Assuming every endpoint can stay awake, buffer, retry, and update like a gateway.
Traffic class
Cadence, bursts, freshness, reliability, direction, duplicate tolerance, and sensitivity.
Constrains queueing, retries, backhaul, priority, monitoring, and data labels.
Using average bandwidth while ignoring bursts, stale state, and recovery behaviour.
Boundary
Gateway, backhaul, segment, platform, and operations ownership.
Constrains allowed flows, diagnostic visibility, failure recovery, and change control.
Drawing one cloud arrow and hiding who owns each network layer.

Practitioner Check

7.5 Under the Hood: Release Gates Keep the Design Honest

Topology is not one picture. A useful design normally separates logical flows, physical placement, and operations records. Logical views show data paths, control paths, protocol translation, trust boundaries, and failure paths. Physical views show device locations, gateways, cable runs, power, obstacles, and service access. Operational views show ownership, monitoring points, expected alarms, fallback modes, reset procedures, and recheck triggers.

The release gate prevents a design from drifting into production with missing records. The team should know which assumptions were measured, which exceptions are bounded, who can diagnose missing data, what health records separate device, gateway, network, and application failures, and what deployment change forces a recheck.

A strong gate is evidence-based rather than ceremonial. It asks for the measurement or pilot result behind the highest-risk assumptions, the exception log for known weak spots, and the operational handoff that explains who sees each health signal. If a floor gateway loses backhaul, operations should be able to distinguish a radio coverage issue, a gateway queue issue, an upstream network issue, and an application ingestion issue. If the design cannot make those failure modes visible, release should pause even when the topology diagram looks tidy. The gate also records what would reopen the decision, such as growth, site changes, firmware changes, or a platform migration.

A tidy topology diagram can hide physical service problems or an absent support owner. Figure 7.3 separates those views before the release gate evaluates them.

Topology record diagram with logical flow, physical placement, and operations readiness views feeding into one complete topology record for release and future design changes.
Figure 7.3: Separate topology views keep logical flow, physical placement, and operations readiness from hiding each other

The Logical Flow column in Figure 7.3 records data and control paths, protocol translation, trust boundaries, and failure paths. Physical Placement instead captures device and gateway sites, cable runs, power, obstacles, and service access; Operations Readiness names ownership, monitoring, expected alarms, fallback modes, resets, and recheck triggers. All three point to the Complete Topology Record. The separation prevents a sound logical route from being mistaken for a maintainable deployment and supplies the distinct evidence the release decision needs.

With the three views assembled, the gate diagram Figure 7.4 tests whether their evidence is sufficient to approve, hold, or narrow the design.

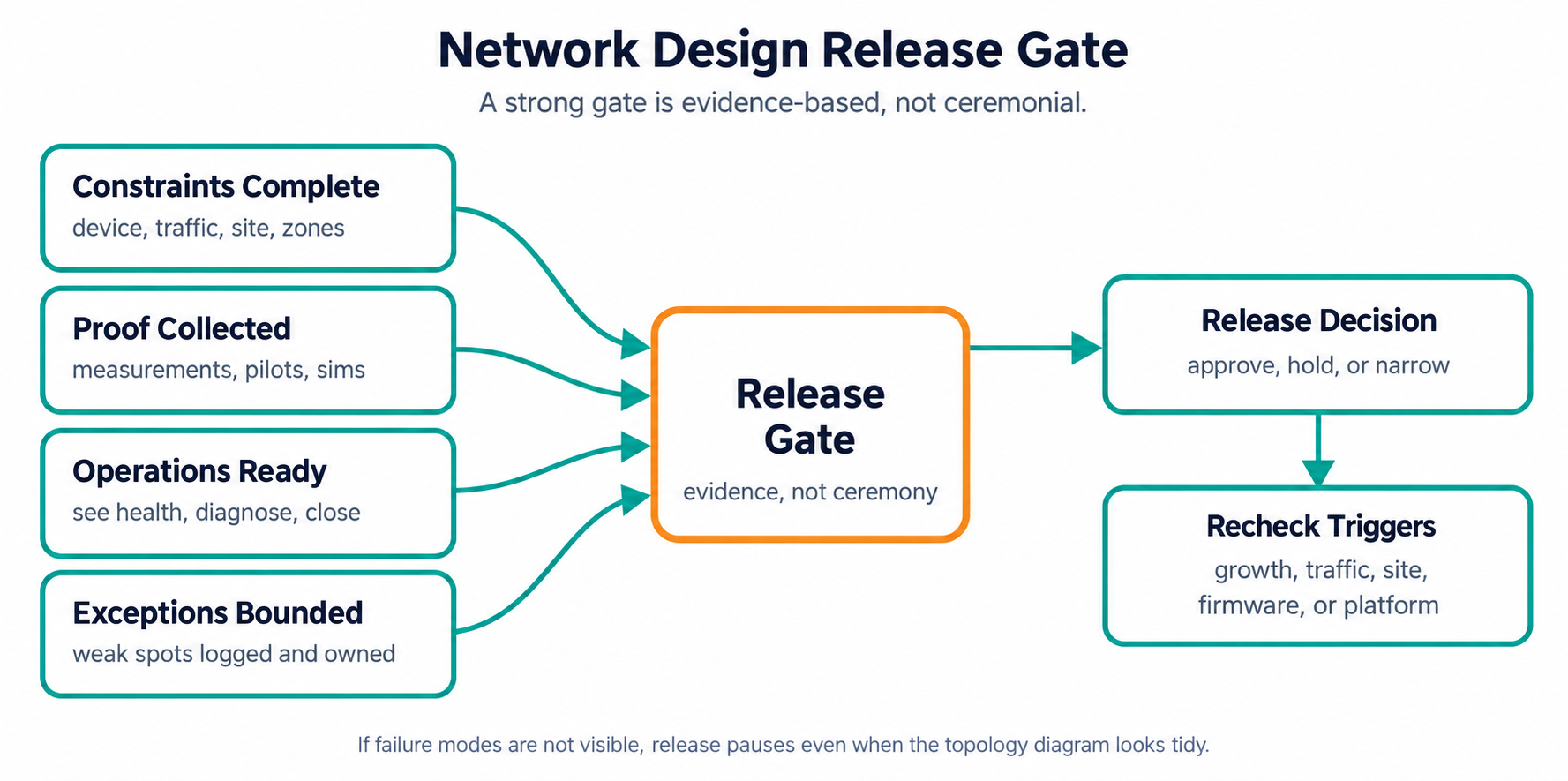

Network design release gate: constraints complete, proof collected, operations ready, and exceptions bounded converge on a release gate that yields a release decision and recheck triggers for growth, traffic, site, firmware, or platform changes.
Figure 7.4: The release gate asks whether constraints, proof, operations, exceptions, and recheck triggers are ready

Four inputs enter the Gate in the diagram Figure 7.4: Constraints Complete, Proof Collected, Operations Ready, and Exceptions Bounded. Their sublabels distinguish recorded device, traffic, site, and zones from measurements or pilots, visible health and diagnosis, and owned weak spots. The gate produces a Release Decision—approve, hold, or narrow—alongside Recheck Triggers for growth, traffic, site, firmware, or platform change. This closes the chapter’s traceability narrative: release is a bounded evidence claim, and the trigger prevents that claim from surviving changed conditions by habit.

Constraints complete

Device classes, traffic classes, site limits, ownership, and security zones are recorded.

Proof collected

Measurements, pilots, coverage checks, packet captures, or simulations cover the highest-risk assumptions.

Operations ready

Support can see health, diagnose missing data, replace devices, and close incidents with records.

Recheck triggers

Growth, new traffic, changed site conditions, firmware changes, or platform migration force another recheck.

Under-the-Hood Check

7.5.1 Interactive: Observe One Missing Fragment Consume Receiver State

The packet-size and reliability gates meet at the reassembly buffer. Use the missing-and-timeout preset below to dispatch four fragments while fragment 3 is absent, then advance the receiver clock to the 60-second discard boundary. The byte-offset map shows why arrival order is recoverable but missing coverage is not.

Carry the held bytes, missing range, and timeout owner into the network-design record. This makes the MTU decision operational: one lost fragment can retain receiver state for the entire datagram and force upper-layer recovery.

7.6 Summary

Network design considerations are useful only when they create traceable records. Start with device constraints and data behaviour, define infrastructure and addressing boundaries, document logical, physical, and operational topology separately, and finish with a release gate that names operations readiness and recheck triggers. This keeps the design decision meaningful even when a protocol, vendor, platform, or site detail changes.

7.7 Key Takeaway

An IoT network design is ready when its protocol, topology, addressing, operations, and release choices can all be traced back to device and data records.
